CurrentlyBusiness Development ManagerSA Property Management Sdn Bhd
Property & strata managementBased in Johor Bahru
From the field
Whattheworkactuallylookslike
Management offices being set up, plant rooms and services checked, keys handed over, and
the meetings where owners get their answers. These are working photographs, taken on site
while the job was being done.
A quick look
Key handover, Parkland Residence Kajang 2
Pool filtration plant
Site walk, takeover
A management office, finished
Annual General Meeting
The approach, cleaned down

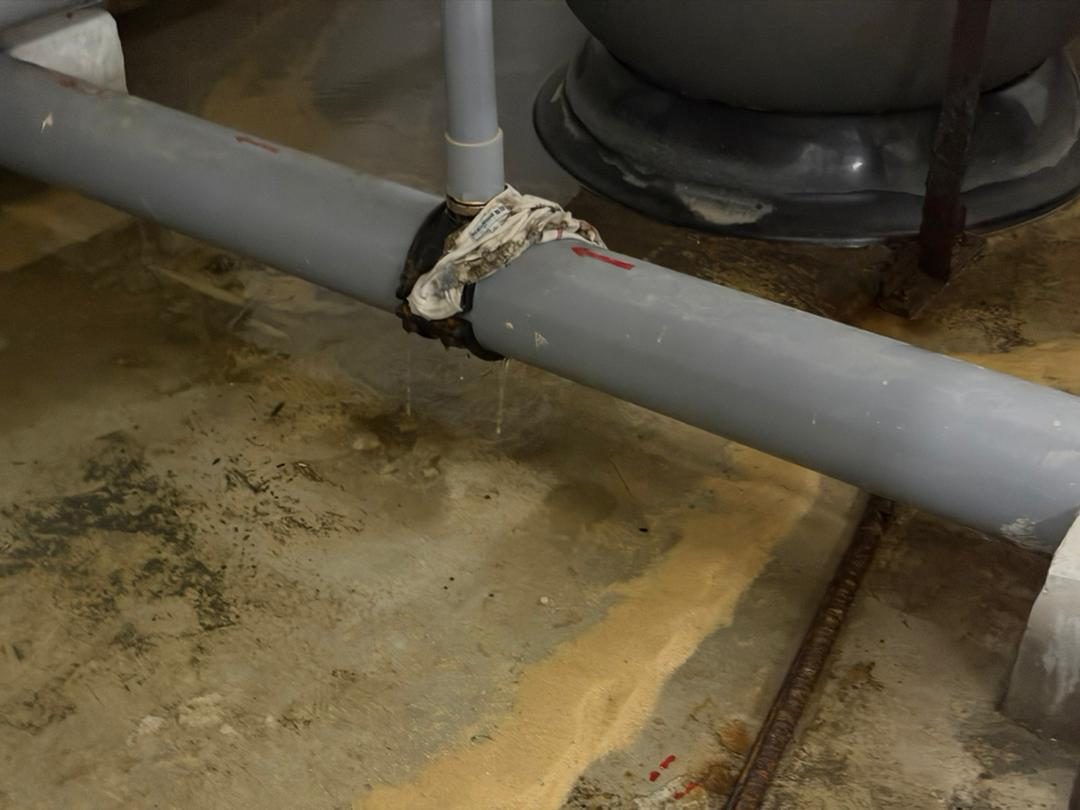

A leak, found
With the team at Meldrum Heights
Pre-Vacant Possession
Getting a building ready to be handed over
Pre-Vacant Possession is the preparation and setting up of the management office, finalising
the key handbook for every unit, and assisting and arranging for vendors to visit the site
before appointment. All of it happens before a single owner collects a key.
Before fit-outThe starting point. An office with nothing in it yet, in a building that already has owners waiting to move in.

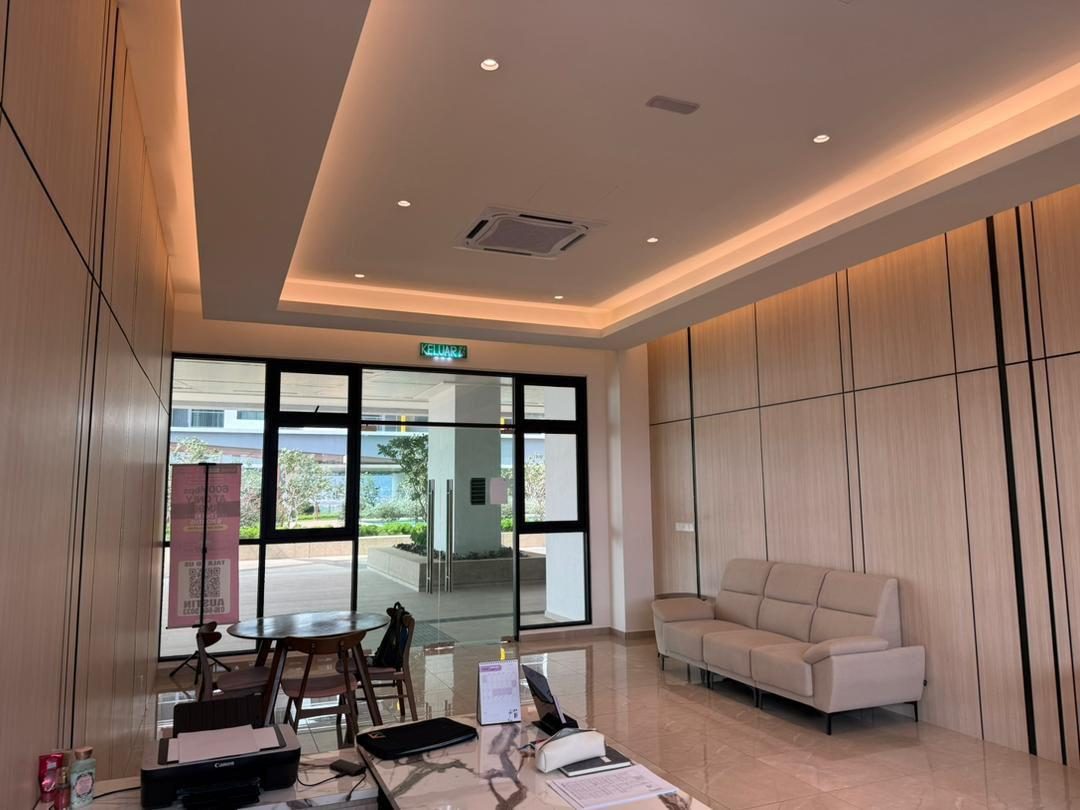

Fit-out in progressDesks in, cabling still on the floor. The office goes together around the people already working in it.
The office in useOnce the desks work, the site has somewhere for records, complaints, contractor sign-in and daily reporting to live.
Reception, part-finishedThe counter is the first thing a resident walks up to, so it is started early and finished last.
Somewhere to sit and settle itOwners, committee members and contractors all end up waiting here at some point. It is worth getting right.
Ready to hand to the site teamA finished management office reception. From here the building has a front desk and a point of contact.

Finalising the key handbookThe key book has to account for every parcel in the development before vacant possession. This set was for the VP of NOA Residence, Melaka.

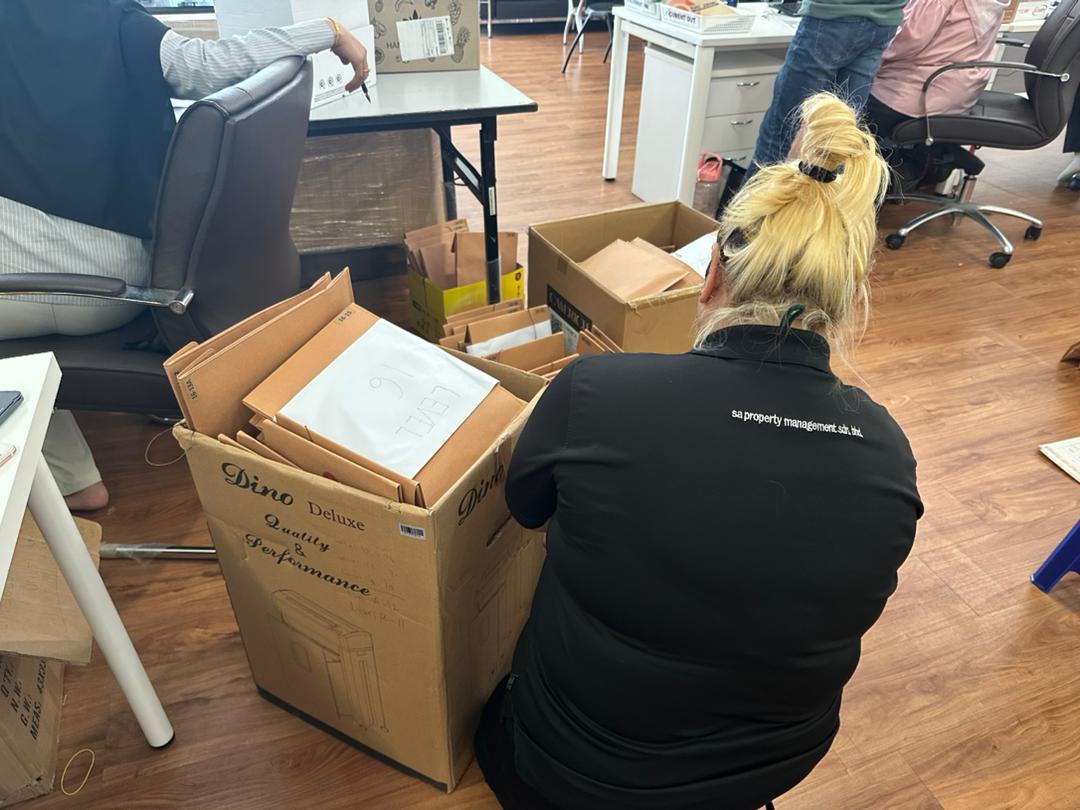

Unit by unitEvery unit gets its own envelope and its own line in the book. Nothing goes out on VP day that has not been checked off here first.

Vendor site visit, before appointmentSite visits are assisted and arranged for vendors before they are appointed by the client, so that everybody quoting has stood in the building first.

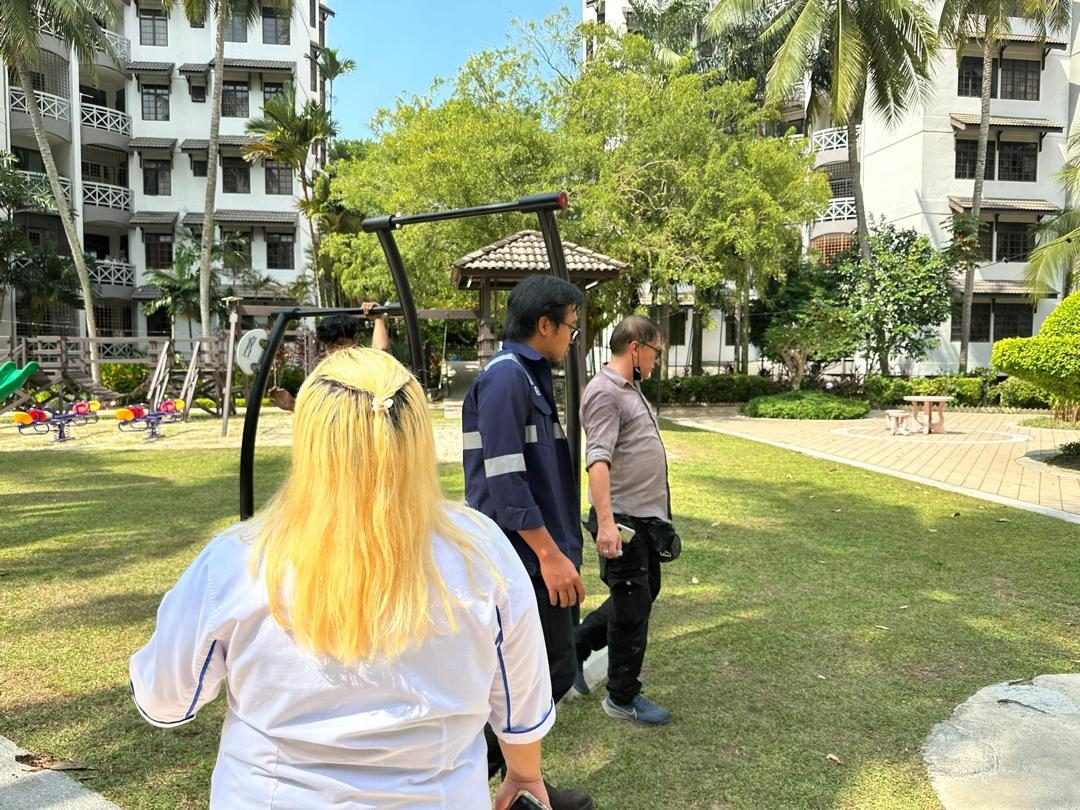

Walking the blockVendors are taken through the development itself rather than a drawing of it. Facade, drop-off and access all change what a package costs.
Going through the scopeSite walk and discussion with KL Team, in order to collect data for the facilities in conjunction of House-Rules preparations

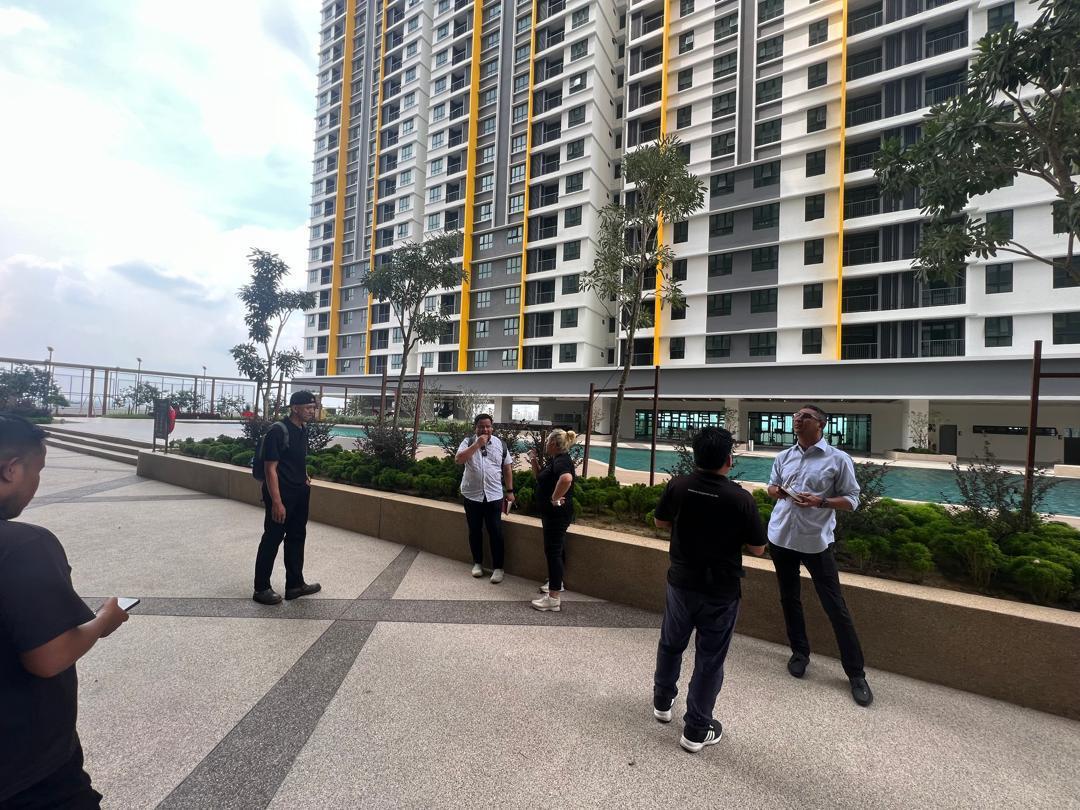

The facilities, on the groundPool deck, landscaping and common areas walked with the vendors, so the quotations that come back cover what is actually there.
An urgent takeoverAn urgent takeover for a persatuan whose existing property management staff had reached their last day. I came in and took the site over at the client's urgent request.
Vacant possession and handover
The day it stops being a project
Vacant possession is the point a completed development becomes somebody's home and
somebody's responsibility. Everything that happens before it is preparation for that
morning.
Key handover ceremony, Parkland Residence Kajang 2The management and developer teams on the morning of the HJ2 handover. Getting to this point is months of work behind the scenes.
Handing it overThis is the moment the developer's project becomes a managed property, and somebody's home.
Walking the entrance roadA pre-handover walk of the arrival route, checking finishes, markings and where water sits after rain. It is also the walk the proposed assembly points come out of, so the evacuation route is settled before anybody moves in.10-second clip, no sound

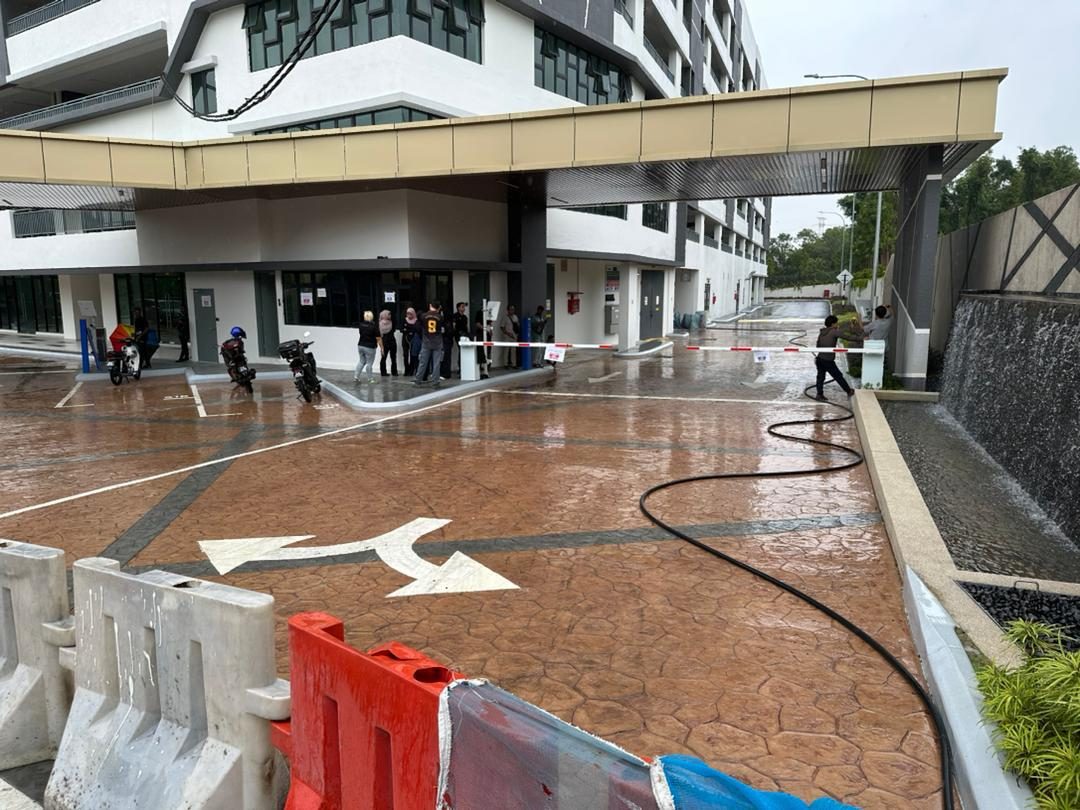

The approach, cleaned downDrop-off, drainage, road markings and barriers all get checked and washed before owners start arriving, site walk at the main entrance in order to propose for "Assembly Point" for the new project.
On the ground
Most of it is walking the site
Building management is mainly a matter of being there, seeing what has gone wrong and
dealing with it before it becomes a complaint at the next general meeting.
Site walk, takeoverWalking the facilities and common areas with the site team as part of the takeover, recording the condition of everything being handed over.
Settling it in front of itThings get resolved faster standing at the problem than they do over email.
Going through the takeover listingLeading the takeover for new projects, making sure every document — Operation, Account and Technical — is handed over as set out in the Takeover Listing.
Records and reportingDuring the takeover, I ensured all related documentations are in order checkbooks accounted for and a well structured filing handover.

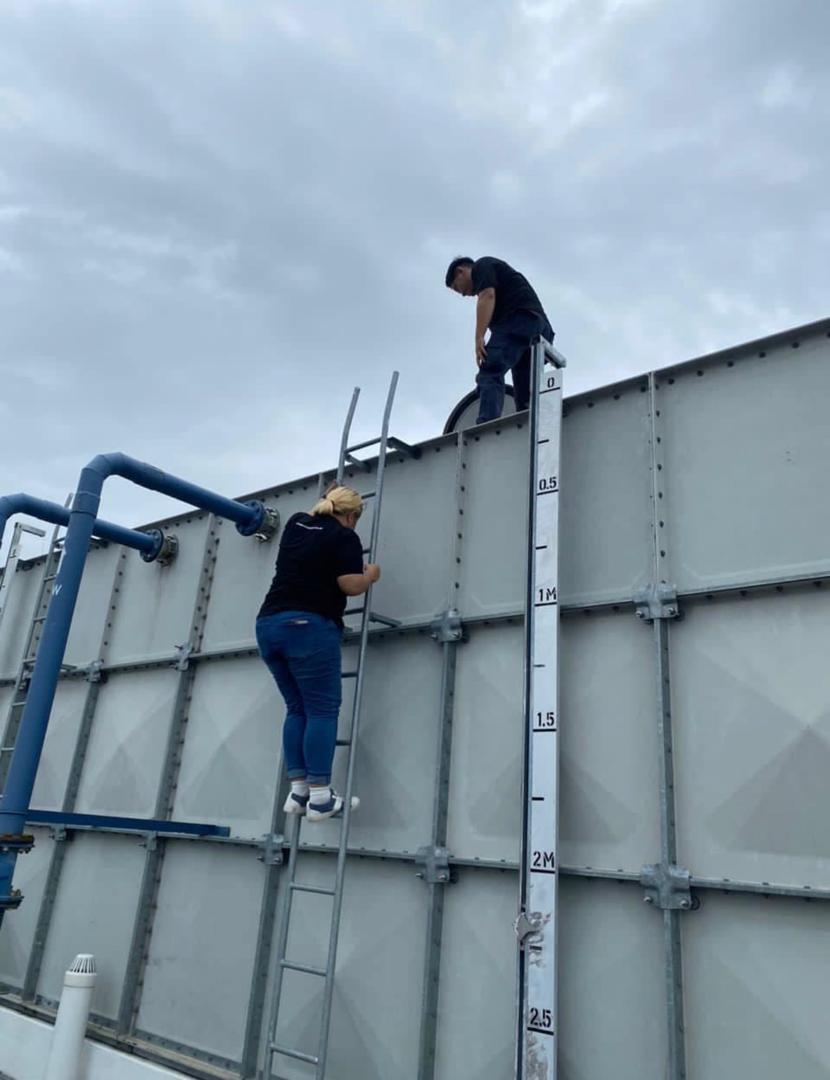

Up on the water tankThe top of a panel tank is the only place you can see inside one, so that is where the check happens.
Team briefingGetting everyone on the same page about what is happening on site that week.
Plant, services and defects
The parts nobody sees
Pumps, filtration, switchgear and pipework are the systems that cost the most when they
fail, and the ones a management office is answerable for when they do.
Pool filtration plantSand filters, pumps and valve sets. Water treatment runs every day whether anyone is swimming or not.

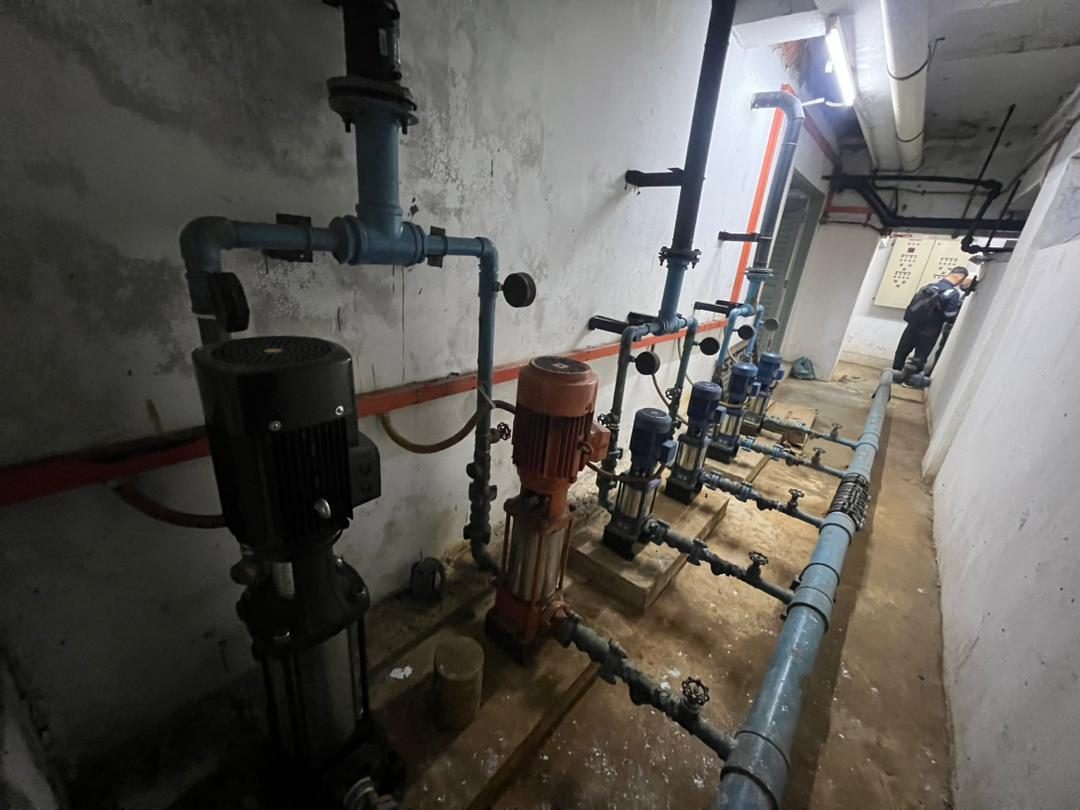

Booster pumpsWhat gets water to the upper floors. Checked on a schedule, not after the first complaint.

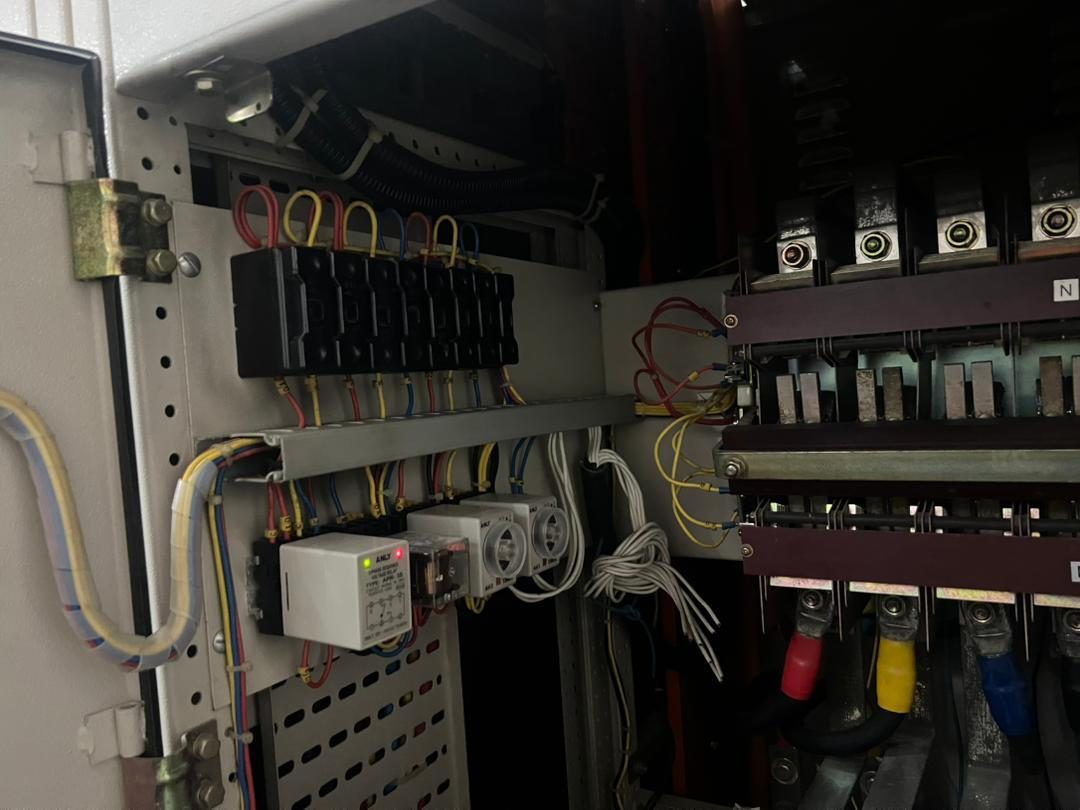

Distribution boardFuses, cabling and terminations checked against the maintenance record and the chargeman's report.

On-site inspection at the poolGoing over the pool edge, the overflow channel and the tiling on site with the team, rather than from a report about it.

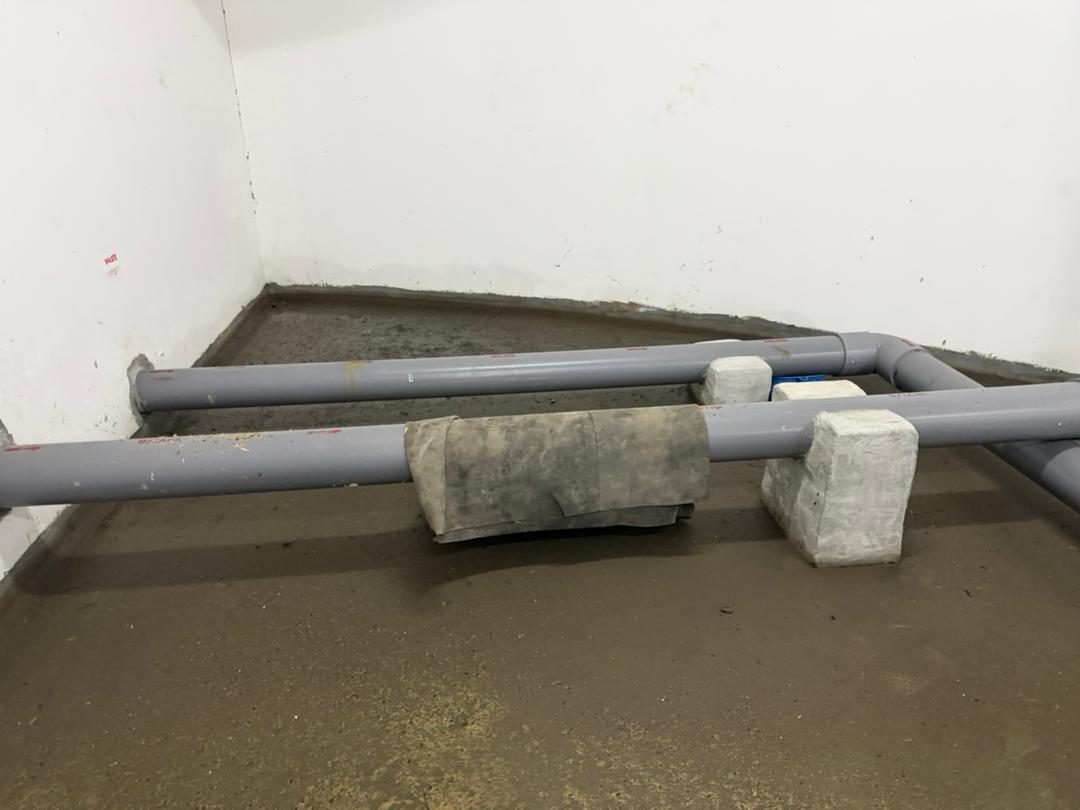

Pipework re-supportedThe main lifted clear of a wet floor on temporary supports while the source of the water is traced.

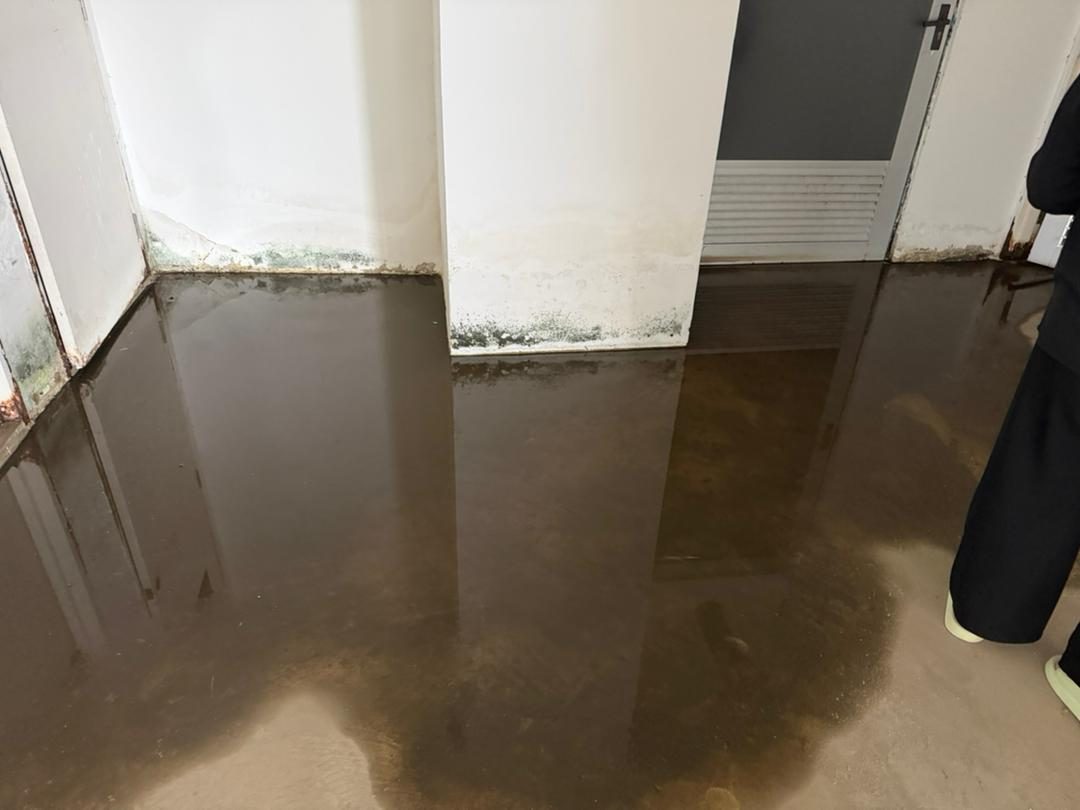

Water ingressStanding water and staining on a slab. Finding where it comes from is the whole job, and the cheapest part of it.

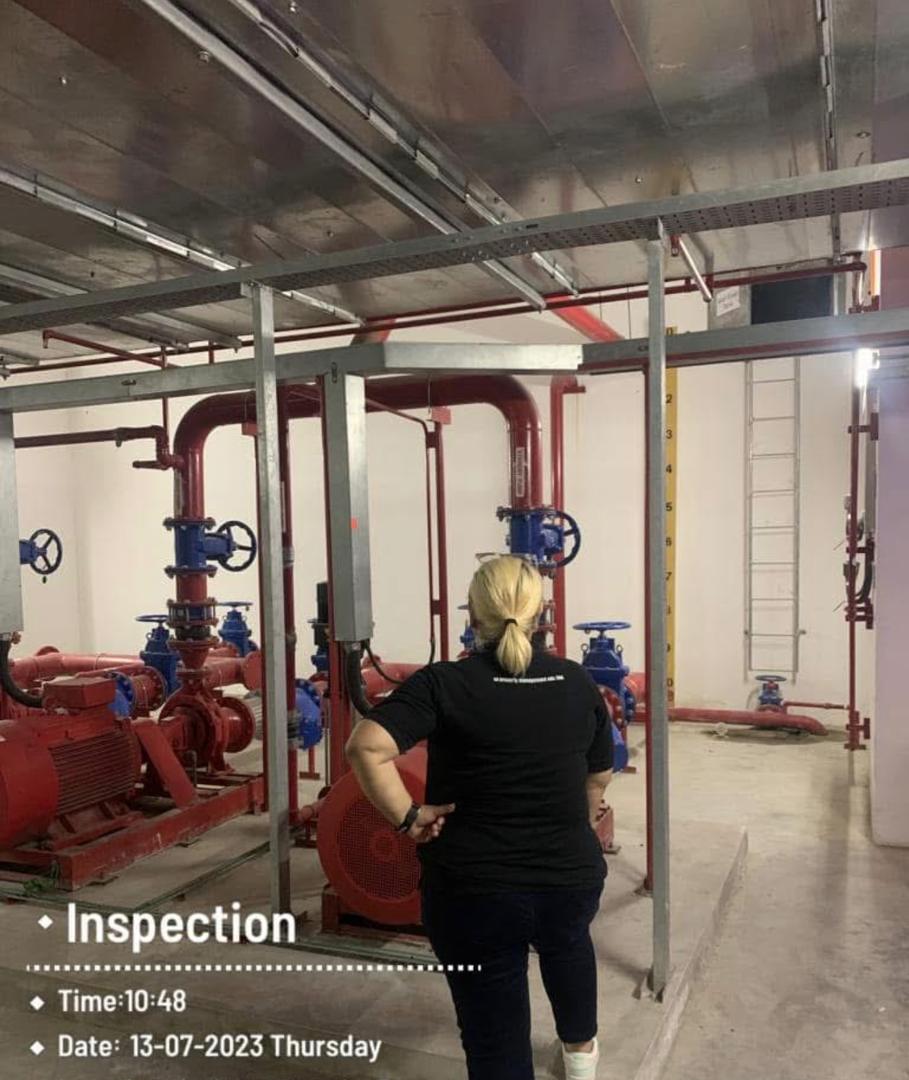

The fire pump roomFire-fighting pumps, valves and pipework. Plant like this is checked on a walk, not from a desk.

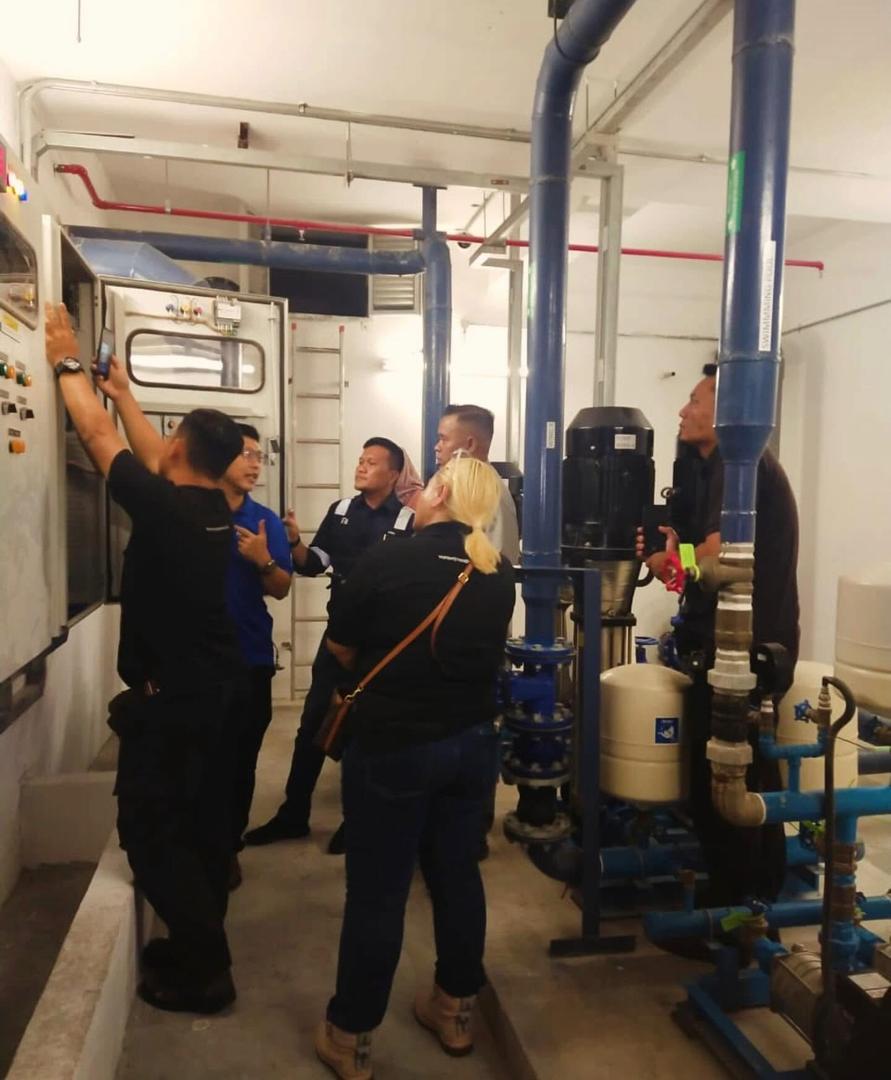

Handover by Main ConThe main contractor walking the installed plant through with us, panel by panel, before it becomes ours to run.

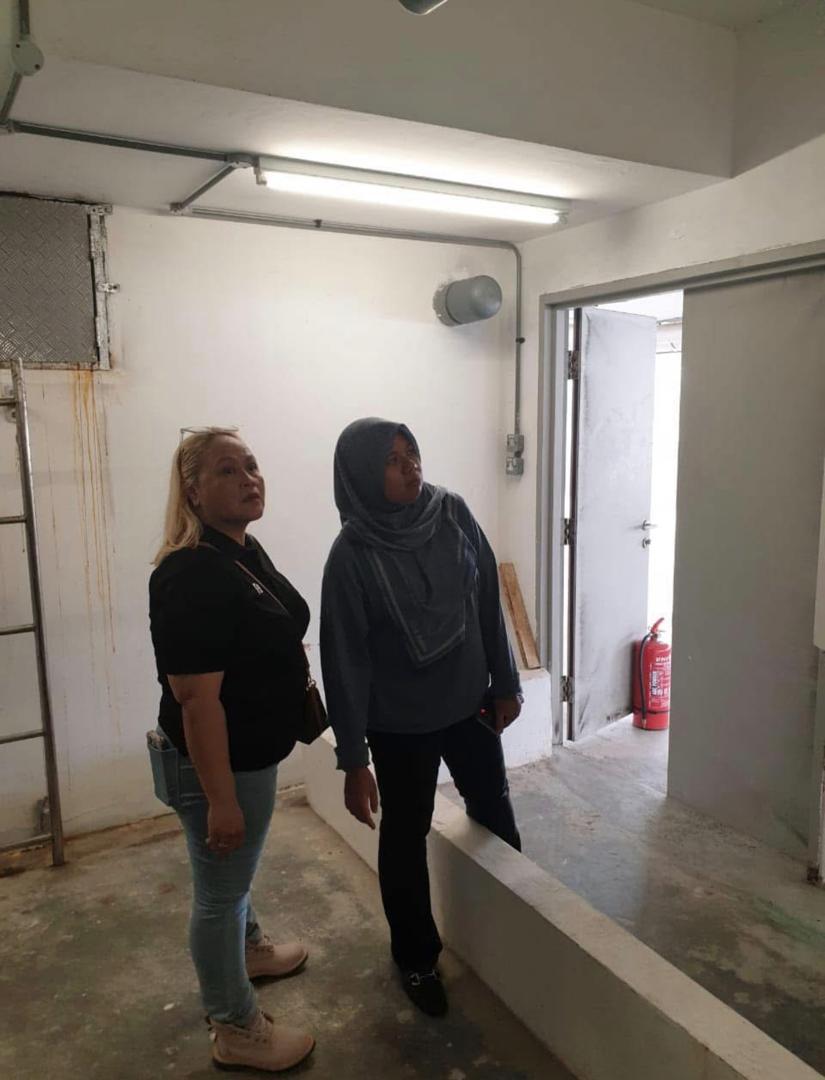

Handover session by developersTaking a room over from the developer. Everything gets looked at before it is signed for, because afterwards it is the building’s problem.

Checking SAJ bulk meterThe bulk meter is where the building’s water bill starts. Reading it is how a billing dispute gets settled, and how a leak first shows up.

Site inspection for renovationRenovation works get inspected while they are happening. What is approved and what is actually being built are not always the same thing.
Annual general meetings, extraordinary general meetings and townhalls are where accounts,
works and complaints are put in front of the people paying for them.
Annual General MeetingOwners turn up in numbers when there is something to settle. The meeting has to be run so that everybody leaves with an answer.
The panel tableQuestions come off the floor and get answered at the table, with the management team there for the detail behind each one.
Presentation of the Agenda, item by itemAccounts, works and outstanding matters taken in the order they are tabled, so that nothing on the agenda is passed over before the meeting closes.
The team
None of it is a one-person job
At the project modelWith the team beside the scale model of a development being taken on.
At Meldrum HeightsWith the team in the lobby at Residensi Meldrum, Johor Bahru.
On the way to a siteTender and assessment work means a lot of travelling to developments long before there is any decision to manage them.
Photographs and clips are from Nelfar's own working archive and show the type of work
described. Unless a development is named in the caption, an image is not tied to a
specific building.
